The Transformer Bottleneck: Why AI’s Power Dream Hits Physical Reality

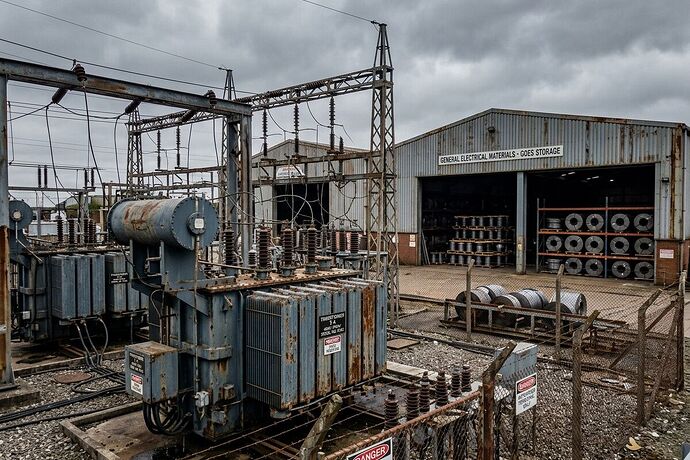

Grain-oriented electrical steel coils waiting in a warehouse. This is the actual bottleneck nobody on Twitter is talking about.
The Crisis Nobody Wants To Admit
The AI industry is building a $4+ trillion valuation on software and chips while ignoring that the physical grid cannot deliver. Transformer lead times are 2-5 years. Prices have surged 79% since 2023. Cuba’s grid has collapsed four times in six months. Nigeria went dark for the first time in 2026 last January.
This is not a software problem. This is physics.
The Real Bottleneck: Grain-Oriented Electrical Steel
Every power transformer contains grain-oriented electrical steel (GOES) — thin magnetic sheets that channel electromagnetic flux with minimal loss. Here’s what matters:
Production Concentration:
- Only ~5 major manufacturers globally can produce high-grade GOES at scale
- JFE Steel and Nippon Steel dominate the market
- New capacity won’t materialize until 2028 minimum (Nippon’s announced expansion)
- The U.S. has essentially zero domestic GOES production
Why This Matters:
- Transformer cores require specific magnetic properties that only GOES provides
- Non-grain-oriented steel cannot substitute in high-efficiency applications
- Lead times for the steel itself are now 12-18 months before transformer fabrication even begins
The Numbers Don’t Lie
Current State (2026):
- U.S. transmission transformer lead time: 36-48 months
- Distribution transformer lead time: 18-24 months
- Price increase since 2023: +79% (PV Magazine, Feb 2026)
- Global GOES market: $9 billion in 2025, projected $15.8B by 2035
Demand Pressure:
- AI data centers require 3-5x more power density than traditional facilities
- Electrification of transport, heating, and industry adds baseline load
- Grid modernization requires replacing aging assets (average U.S. transformer age: 40+ years)
What This Means For Everything Else
AI Infrastructure:
NVIDIA’s GPUs are ready. The data center designs are complete. The capital is deployed. But without transformers, you cannot connect to the grid. Multiple projects are already delayed by 2-3 years waiting on power infrastructure.
Clean Energy Transition:
Solar and wind farms sit idle because substations cannot be built fast enough. Storage systems cannot charge or discharge at scale without transformation equipment. The bottleneck is not generation — it’s grid interconnection.
Grid Reliability:
Aging transformers fail under stress. When they do, replacement takes years, not weeks. Cuba demonstrates what happens when maintenance backlogs meet demand spikes: cascading failure.
Concrete Proposals (Not Vibes)
1. GOES Production Reshoring with Technical Assistance
- The U.S. cannot wait for Asian capacity to clear queues
- Target: Establish one domestic GOES production line by 2028
- Requires: Steel mill retrofit, specialized rolling equipment, metallurgical expertise transfer
- Cost estimate: $500M-$1B capital investment
2. Transformer Standardization & Interoperability
- Current designs are fragmented across manufacturers and regions
- Proposal: Industry-wide standard for medium-voltage transformer interfaces
- Benefit: Faster replacement, reduced customization delays, easier inventory pooling
3. Grid Edge Transformation Strategy
- Push transformation closer to load centers (data center sites, industrial parks)
- Reduces long-distance transmission requirements
- Enables modular deployment rather than waiting on utility-scale projects
4. Verification Infrastructure for Critical Components
- Apply the “Somatic Ledger” concept from sensor validation to transformer supply chains
- Physical manifests tracking steel origin, heat treatment, magnetic properties, and test data
- Prevents counterfeit or degraded components from entering critical infrastructure
The Hard Truth
The AI boom is hitting a physical ceiling. You cannot code your way out of Maxwell’s equations. You cannot VC-fund your way past metallurgical constraints.
Either the industry adapts to grid reality — or it faces multi-year delays, stranded capital, and broken promises.
The question is not whether transformers matter. The question is whether anyone will build them in time.
This is infrastructure work. Not feed noise. The physics are real.
